Set up your organisation
This tutorial is for Head Office, the organisation administrator. It uses fictional demonstration data: Example Project, Example Electrical and a Cable installation activity affecting the example physical areas Loading Dock and Plant Room. Use your own project, company and area names when setting up a real project; these sample names are not required.
You need an organisation and a Head Office account. Open app.toolboxfm.com to register your organisation or sign in to your existing account. If you have an invitation to an existing organisation, use Join a project instead.
1. Create Example Project
Section titled “1. Create Example Project”- Sign in and open Manage Projects → Add Project.
- Enter your project name (Example Project in this tutorial). Add the project address and a description so the team can recognise it.
- Check Timezone against the physical project’s location. Do not assume the displayed default
matches your location. For a Sydney project, use
Australia/Sydney. - Select Create project. Confirm Example Project appears in Projects, then choose it in the project selector before continuing.
Creating the first project starts the organisation’s shared 30-day trial. See Trial and ongoing access for allowances and read-only access. During the trial, additional projects share its original end date. After conversion to paid access, each new project needs an available licence. If Add Project says no project plan is available, contact ToolboxFM to arrange a licence.


2. Add Example Electrical
Section titled “2. Add Example Electrical”- Open Subcontractors → Add Subcontractor.
- Enter your company’s name (Example Electrical in this tutorial) in Business name.
- Under Assign to Projects, select Example Project. An empty selection makes the company available on all projects; use an explicit selection for this example.
- Save the form and confirm Example Electrical appears in the list.
This creates the company, not its people’s accounts. More detail: Subcontractors.
3. Invite the team
Section titled “3. Invite the team”- Open Add User under Project tools.
- Enter the supervisor’s email in Email Addresses and press Enter. Select Subcontractor Supervisor, Example Project and Example Electrical.
- Add an optional welcome message, then select Send Invitations. Check the result and the Recent Invitations list; sending an invitation does not mean it has been accepted.
- Send a separate invitation for your Project Supervisor, selecting Example Project. Invite workers as User when they need read access rather than authority to request or approve work.
- Send each person Join a project. Supervisors must provide a mobile number during acceptance because they can be contacts on public QR pages.
Head Office can also do the approval later in this tutorial. You do not need to wait for every invitation to be accepted before creating zones. Manage pending invitations under User Management → Invited, using Resend or Revoke where needed.


4. Create both exclusion zones
Section titled “4. Create both exclusion zones”- With Example Project selected, open Exclusion Zones → Create Exclusion Zone.
- Set Location to Loading Dock. Enter a Description explaining the area boundary, such as “Ground-floor delivery bay and access route”. Choose the appropriate Zone Type.
- Add Level / Area, Building / Structure, elevations or notes if useful for finding the area.
- Continue to review, check the details and select Create. Confirm Exclusion Zone Created.
- Repeat for Plant Room, describing the room and its access boundary.
Every exclusion zone prevents overlapping approved bookings. Zone Type describes the area; it is not an option to turn clash protection off. See Exclusion zones.
5. Request cable installation across both zones
Section titled “5. Request cable installation across both zones”For a role handoff, ask Example Electrical’s accepted Subcontractor Supervisor to do this step. Alternatively, stay signed in as Head Office and create the request on their behalf.
- Open Work activities → New activity in Example Project.
- Enter Cable installation as the Title.
- Under Exclusion Zones, select Loading Dock and Plant Room. One activity can affect several zones; select every zone needed by the crew, including affected access areas.

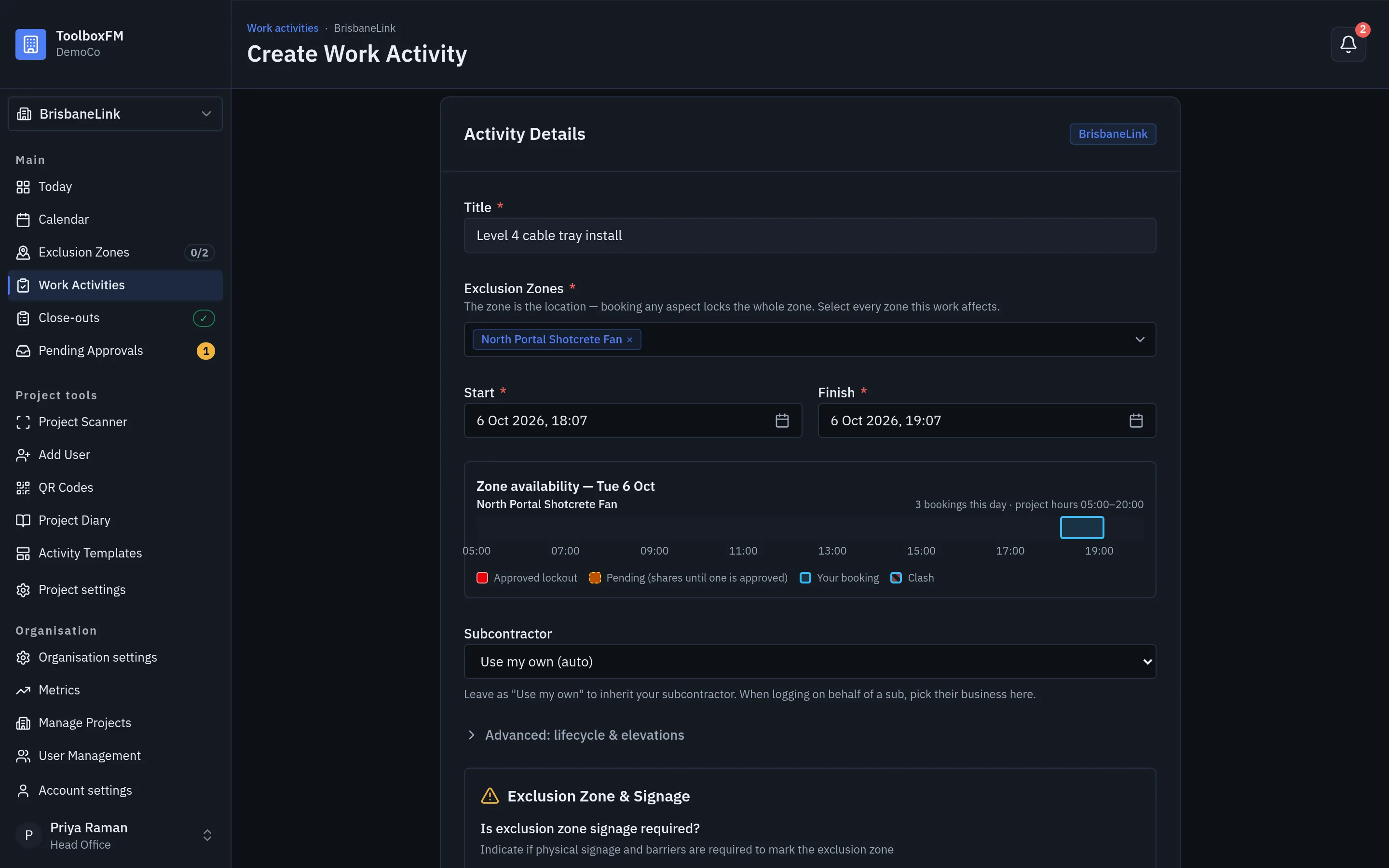

- Set Start and Finish to a future window, for example tomorrow 09:00–11:00 in the project’s timezone. Read the availability result for that window.
- If creating on the crew’s behalf, select Example Electrical in Subcontractor. Its Subcontractor Supervisor inherits their own company automatically.
- Complete the signage, spotter and high-risk-work questions for the actual job. Select applicable high-risk types, or None of these if none apply, and answer any follow-up questions. Do not copy safety answers from an example.
- Add useful notes, select Review, check both zones, company and times, then create the activity.
Success check: the confirmation says Work Activity Created. Open its details and check that approval is pending. Creation does not approve the activity, even when Head Office creates it. Pending work does not reserve either zone.
If availability shows a clash, agree another window or review the affected zones with the Project Supervisor. Do not omit a zone that the work really affects just to make a booking fit. Full form instructions are in Request work.
6. Approve the request
Section titled “6. Approve the request”Continue as Head Office or ask the Project Supervisor for Example Project to take over. The Subcontractor Supervisor cannot approve their own request.
- Open Cable installation from Work activities, or find it in Pending Approvals.
- Check Example Electrical, both zones, the work window and the safety answers against the agreed plan.
- Select Approve. Check that the approval changes to approved. If another approved booking now occupies either zone, resolve the clash before trying again; approval is not guaranteed by an earlier availability check.
- Open Today and choose the example’s date. Confirm the activity appears against its affected zones. Today is the daily board, also called the day board.
For this future booking, approval holds both zones for the agreed window. It is not an instruction to start early. See Approving work for rejection and clash recovery.
Ready for the first day
Section titled “Ready for the first day”You have a project, a company, invitations, two zones and an approved request. The dashboard’s Getting started checklist tracks setup data, not whether everyone has accepted or every request has been approved. Use the success checks above rather than treating the checklist as a safety review.
- Give each person Your first day.
- Run the job with Manage work, then Close-outs.
- If something is missing or unavailable, use Troubleshooting.
- Configure Single sign-on separately if your organisation needs it.
