Approving work

Only Head Office and Project Supervisors have approve work activities permission. Project Supervisors need authority on the activity’s project. Subcontractor Supervisors and Users cannot approve, even if they created the request.

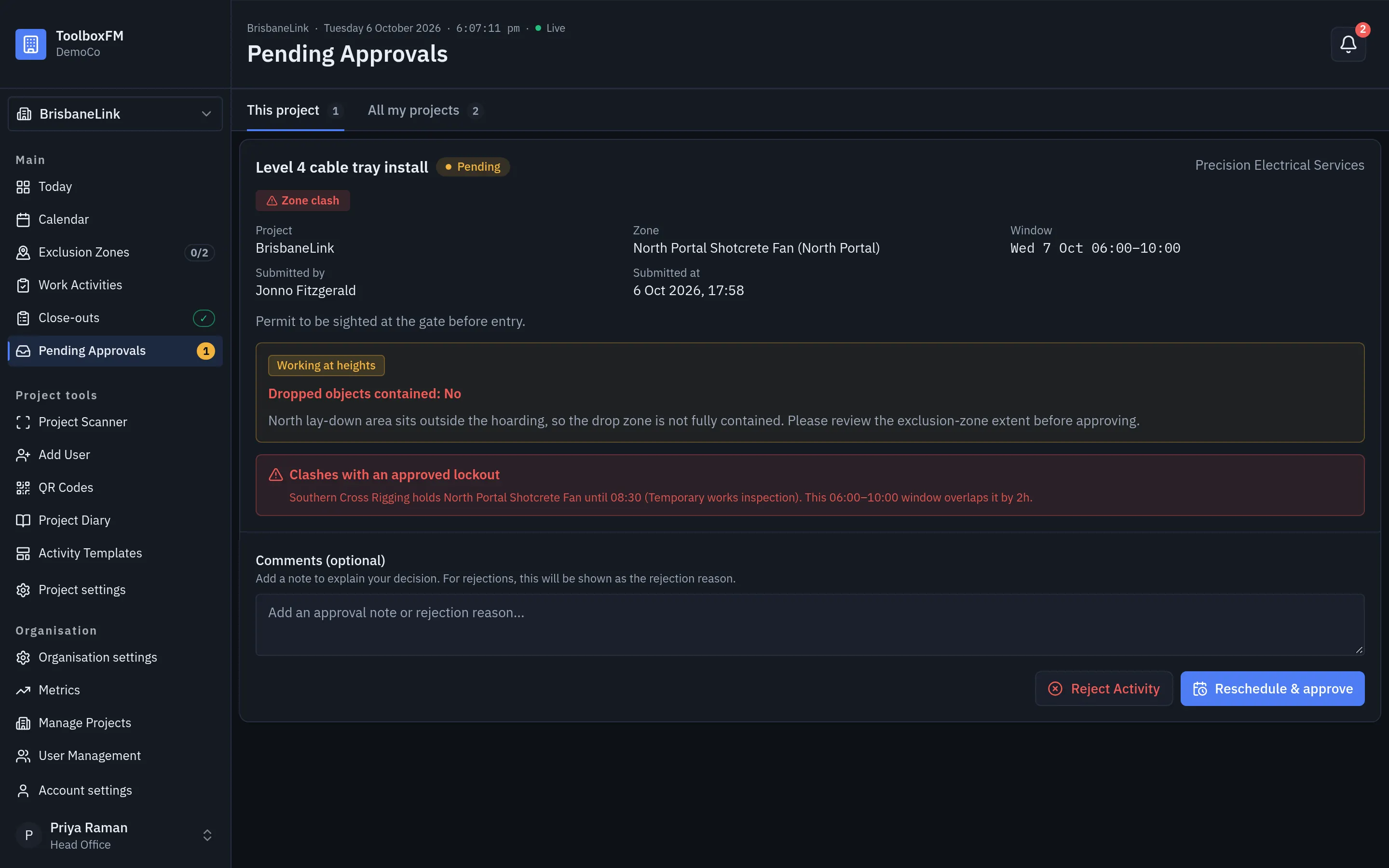

An approval request showing high-risk work, dropped-objects answers and a booking clashAn approval request showing high-risk work, dropped-objects answers and a booking clash
Read the request and any clash before recording a decision. This screenshot predates the consultation confirmation and separate approval-mitigations field described below.
  1. Open Pending Approvals and find the request for the correct project and subcontractor.
  2. Check the title, all affected zones, start and finish, spotter, signage, notes and high-risk answers. Example Electrical’s cable installation needs both Loading Dock and Plant Room checked.
  3. Read any dropped-objects answer and the requester’s optional comment. Dropped objects contained: No allows submission, but requires site supervisor consultation and further approval. Consult with the requester about the increased risk and agree on mitigations before approving. Arrange that discussion directly; ToolboxFM records your confirmation, not the conversation itself.
  4. For concrete pumping and placement, read Excluded below placement:
    • A zone name: that zone is booked as the area below. Check it is the right level or location, and that the request also books the placement area, such as the leading deck. Both zones are locked out for the same times.
    • Not set up as a zone: read the requester’s description of the area below and how it is excluded. This requires consultation, the same as a dropped-objects No. Verify the exclusion, or set up a zone and ask the requester to add it to the request.
    • Nothing below: for example, a slab on ground.
  5. Check Today and Calendar for other requests and approved work. A contested slot with other pending requests is different from a clash with an approved booking.
  6. For a dropped-objects No, or an area below that is not set up as a zone, explicitly check I have consulted with the requester about the risk and mitigations. You may add Approval reason and mitigations (optional) in its separate field; text alone does not replace the required confirmation. Use Rejection reason (optional) if rejecting instead. For other requests, use Comments (optional) for a decision note. Choose Approve Activity if the request can proceed, or Reject Activity and explain what needs to change.
  7. Reopen the activity to confirm the decision. Future approved work stays scheduled; an approved window already in progress can activate immediately. Rejected work has no approved zone booking.

For a proposed change, compare the displayed old and new values and use Approve Edit or Reject Edit. Rejecting an edit leaves the existing activity unchanged; it is not cancellation.

The consultation confirmation is also required when approving a proposed edit with either consultation answer, using Log as completed for retroactive approval, or using Reschedule & approve. The approval reason and mitigation text remains optional in each case. These requirements do not change who has permission to approve.

After approval, the activity’s High-risk work panel shows Requester consultation confirmed, who confirmed it and when, plus any saved approval reason and mitigations. The requester’s optional dropped-objects comment and area-below description remain separate from the approver’s notes. The project diary shows compact risk pills and a View HRW details link rather than repeating these notes.

Pending requests do not reserve zones. Approval of scheduled or active work holds each linked zone for its booked window. A clash in just Plant Room can prevent approval of the whole multi-zone request.

  1. Read Clashes with an approved lockout and identify the blocking activity, zone and window.
  2. Coordinate with the affected supervisors. Decide whether to move the request or change the existing booking through its authorised owner. Do not omit a genuinely affected zone to force approval.
  3. Choose Reschedule & approve and select an offered window, or Pick a custom time instead. Check all zones and confirm with Reschedule & approve. Contested means another pending request uses that slot, not that an approved booking has already taken it.
  4. Confirm the revised time and approval on the activity, then tell the crew which window to use.

If the slot becomes occupied before confirmation, choose another agreed window and try again. The action does not override the blocking booking. Restricted projects can prevent rescheduling; ask Head Office to review Trial and upgrading.

Approving one request can leave a competing pending request Bumped. The creator and its company’s supervisors receive a notification, but also coordinate the new plan with the crew.

  1. Open the bumped request from Today and identify the approved booking it conflicts with.
  2. Reschedule it into an available window and approve when appropriate, or reject it with a useful note.
  3. Recheck Today after changing or cancelling the blocking booking; bumped labels reflect the current bookings and can clear when the conflict is removed.

When a request’s entire window has passed, Resolve replaces plain approval.

  1. Open Resolve and establish what actually happened with the crew.
  2. If the work happened, an authorised approver can choose Log as completed and then arrange its close-out. Do not use this to claim unfinished work is complete.
  3. If it is still needed, choose Reschedule & approve for a future window; otherwise reject the request with a reason, or cancel scheduled work where appropriate.

Do not approve an expired window as if it were a future booking. Use Managing work for already-approved overdue work.

If you approved the wrong request, review the activity with its supervisor: cancel it if still scheduled, or end it if already running, and then recheck the competing requests.
